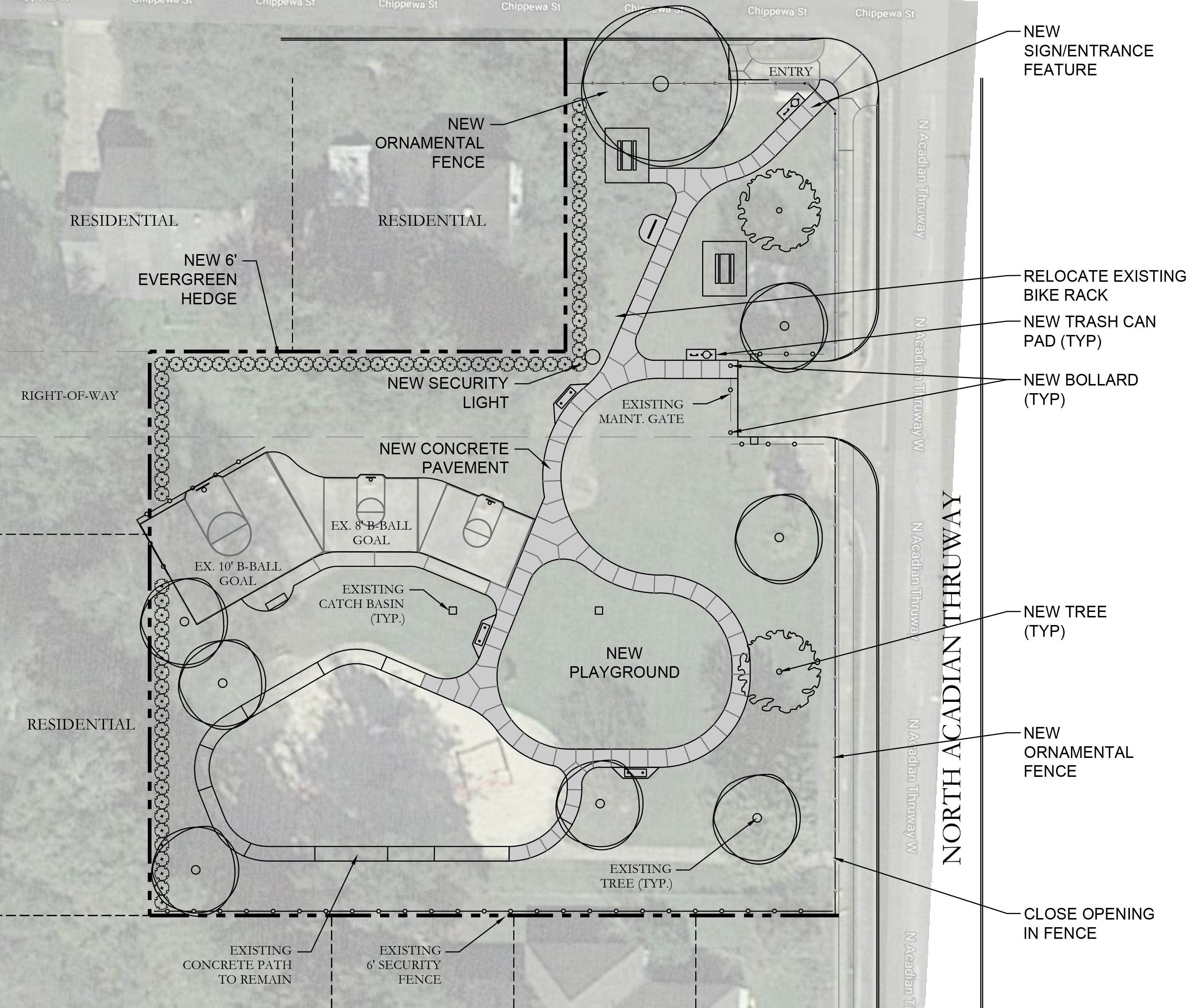

Acadian Thruway - Park Improvements
New Features in Current Project Improvements:
- New Playground
- Improved Basketball Court
- Improved Walking Path
- New Security Lighting
- New Fence & hedges
Project Updates
- May 2018 - Park identified for improvements;
- August 2018 - Online public input survey conducted
- September 2018 - Project in design
- November 2018 - Construction Underway
- December 2018 - Construction 20% Complete
- January 2019 - 25% Complete, waiting to pour concrete for walking path. Pending dry weather.
- February 2019 - 90% Complete, fencing left
- March 2019 - 95% complete, Ornamental Fencing being put in, Sod & Seed next
- April 2019 - 99% complete, Final paint, clean up, Finishing touches on fence, New signage completed
Completion Date: Spring 2019
