Cohn Arboretum - Improvements

Visit Facility Page


(Click to enlarge)

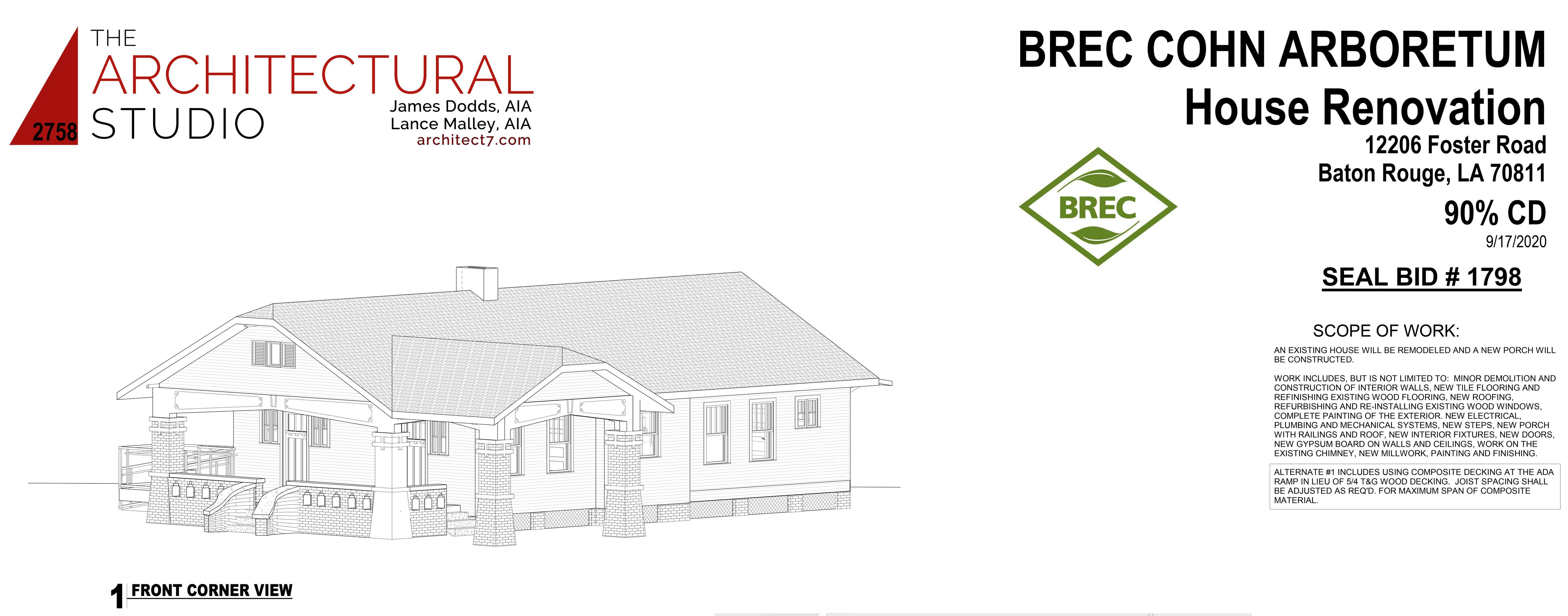

New Features in Current Project Improvements:

  • Renovated bungalow

Project Updates

  • September 2020 - Project completed design phase, project to go out to bid soon
  • November 2020 - Project in bidding
  • February 2021 - 15% Complete, project underway and roof completed
  • March 2021 - 20% Complete, construction continuing
  • April 2021 - 40% Complete, abatement completed, construction continuing
  • June 2021 - 80% Complete, renovation construction continuing
  • July 2021 - 90% Complete, renovation construction continuing.
  • August 2021 - 95% Complete, renovation construction continuing.
  • November 2021 - 98% Complete, project is substantally completed, contractor is working on punch list items.
  • February 2022 - 99% Complete, final inspections in February.
  • May 2022- 100% Complete, building is completed. Recreation to take hold of building from P&E.

Completed Spring 2022


Previous Improvements

Features:

  • Renovated historical building (including abatement)

COMPLETED SUMMER 2020 (Click to view project timeline)

Project Updates

  • DECEMBER 2018 - Project in design
  • JANUARY 2020 - Abatement advertised
  • SEPTEMBER 2020 - 100% complete, lead containing paint stabilization complete
