Frenchtown Road Conservation Area - Improvements

Visit Facility Page

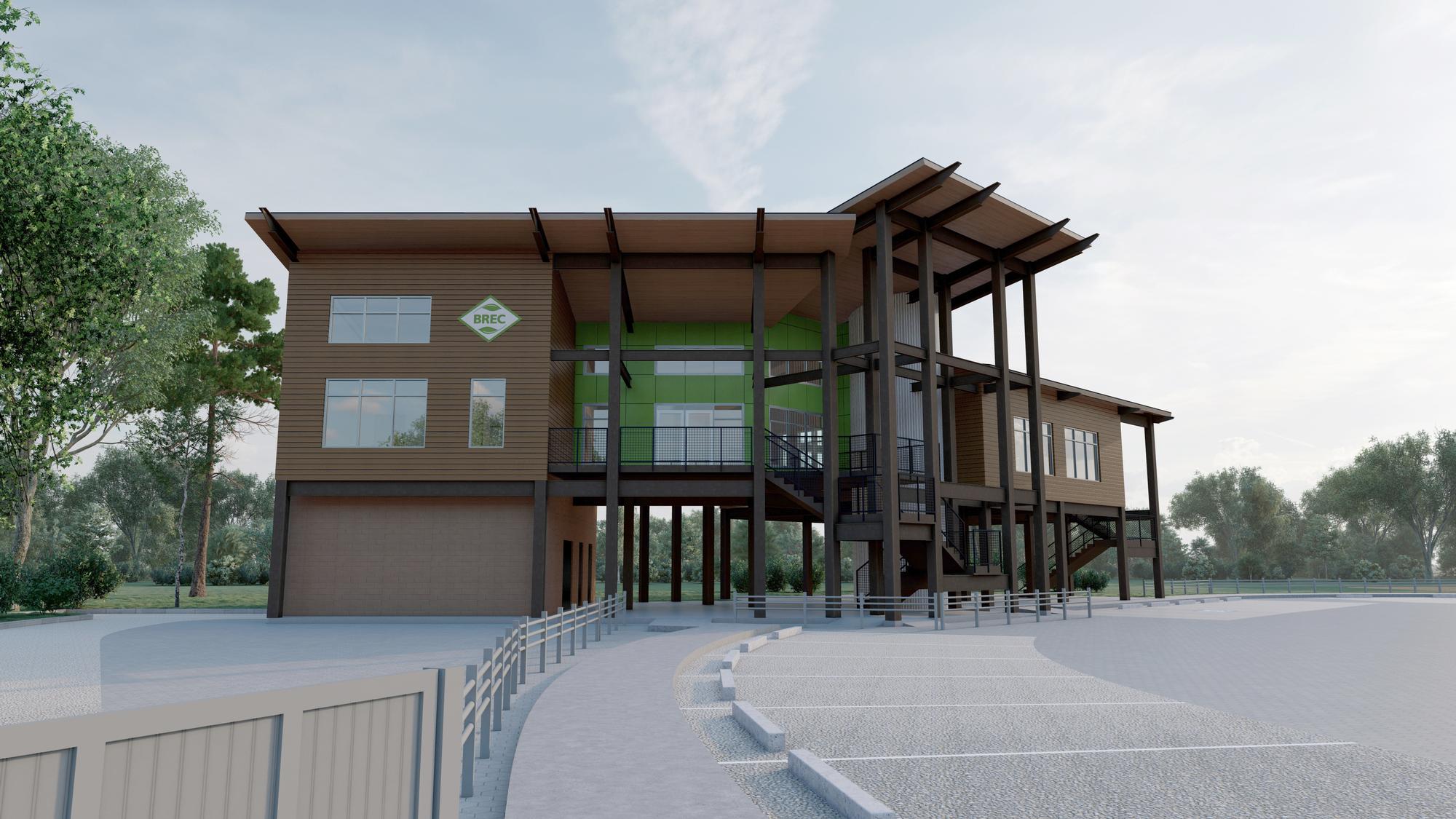

3d Rendering of new elevated building with parking lot
(Click to enlarge)



New Features in Current Project Improvements:

  • New Education Building
  • New Water Well

Project Updates

  • December 2018 - Project in design
  • February 2019 - bid preparations; adjustments made for fire code specifications
  • July 2019 - Public input meetings conducted; public input survey conducted
  • October 2019 - Permitting
  • September 2020 - In contracting
  • November 2020 - In pre-construction phase, Construction to begin soon
  • January 2021 - Notice to Proceed issued early January, construction underway
  • February 2021 - 8% Complete, site demo is complete and forming up slab of building
  • March 2021 - 15% Complete, Building slab construction underway
  • April 2021 - 20% Complete, Building slab complete, structural steel to be installed
  • June 2021 - 40% Complete, structural steel installation underway
  • August 2021 - 50% Complete, structural steel installation complete and concrete decking has been installed.
  • November 2021 - 60% Complete, Installation of steel stud framing and running interior electrical and plumbing.
  • February 2022 - 70% Complete, Roofing installation underway, waterproofing of building, and exterior doors and windows being installed.
  • May 2022 - 85% Complete, proceeding with interior finish work.
  • June 2022 - 90% Complete, interior finish work continues, starting parking lot and exterior site work.
  • August 2022 - 95% Complete, building is substantially completed, bid will go out for water well.
  • November 2022 - 95% Complete, pre-construction meeting for water well has occurred and water well construction to begin in Fall 2022.
  • February 2023 - 95% Complete, Steel construction to begin soon on water well building.
  • March 2023 - 95% Complete, materials for steel construction on order.  Installation to begin soon.
  • April 2023 - 96% Complete, Well water building structure has been assembled.  Construction continues on well water building.
  • May 2023 - 97% Complete, Well water plumbing is in progress and electrical work is underway.
  • June & July 2023 - 98% Complete, formulating punch list for the well structure and awaiting inspection and occupancy.
  • November 2023 - 99% complete, awaiting occupancy

Estimated Completion for Current Improvements: Winter 2023
