Lovett Road Park Improvements

Visit Facility Page

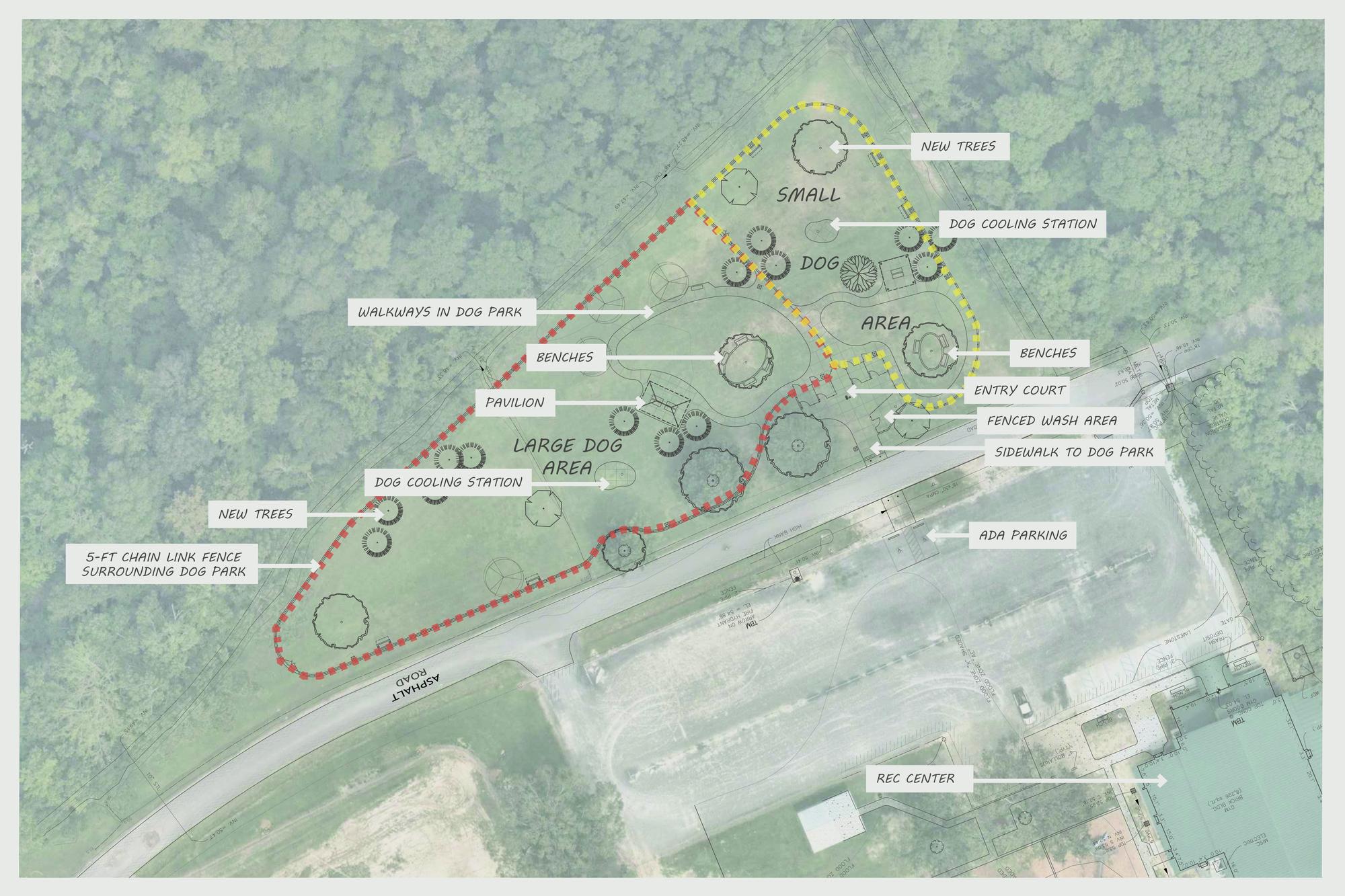

Lovett Road Dog Park Render
(Click to enlarge)

New Features in Current Project Improvements:

  • NEW Dog Park
  • NEW Rinse Dog Stations
  • NEW Pavilions
  • MORE Trees / Shade
  • NEW Drinking Fountain
  • NEW Fencing with SEPARATE small & large dogs areas

Project Updates

  • January 2020 - In design, Topo survey completed
  • March 2020 - Conducted online public input survey. Download Results Here
  • APRIL/MAY 2020 – Analysis of Online Survey, Schematic Design, Design Development
  • September 2020 - Project in design
  • October 2020 - Project out to bid
  • November 2020 - Project in contracting
  • January 2021 - 2% Complete, construction project has begun
  • February 2021 - 8% Complete, drainage construction has begun
  • March 2021 - 30% Complete, pavilions have been installed and fence is partially installed
  • April 2021 - 40% Complete, additional fencing and pavilion roof panels have been installed and sidewalks have been concreted poured.
  • June 2021 - 50% Complete, additional fencing continuing and crushed stone has been installed in large dog section.
  • July 2021 - 80% Complete, construction continuing. Fencing, crushed stone, and concrete has been completed.
  • August 2021 - 90% Complete, project drainage and punch list items to be completed.
  • November 2021 - 100% Complete, dog park project is completed. Set to reopen to the public December 2021






Previous Improvements

Features

  • REPAIRED Flood damage
  • NEW multi-purpose rooms with kitchenette & storage space
  • NEW restrooms
  • NEW heat & air conditioning in all rooms & gym
  • NEW basketball goal systems
  • NEW entry pavilion
  • NEW roof

COMPLETED SPRING 2020 (Click to view project timeline)

Project Updates:

  • JULY 2018 - Project out for bid; Bid awarded to BDS Construction
  • AUGUST 2018 - Permitting
  • OCTOBER 2018 - Construction underway
  • DECEMBER 2018 - Demolition Phase
  • JANUARY 2019 - Building slab addition and utilities. Pending dry weather.
  • FEBRUARY 2019 - HVAC going in; walls going up on most of building; more slab work to happen due to poor soil quality
  • APRIL 2019 - 40% Complete, Framing and concrete going up
  • JUNE 2019 - 50% Complete, Framing and concrete going in, continuing construction
  • JULY 2019 - 60% Complete, Roof installation & wall framing going up, continuing construction
  • SEPTEMBER 2019 - 70% Complete, Continuing construction
  • NOVEMBER 2019 - 80% Complete, Continuing construction
  • JANUARY 2020 - 85% Complete, Continuing construction
  • MARCH 2020 - March 2020 - 90% Complete, Continuing construction
  • JUNE 2020 - 100% complete; Ribbon Cutting event postponed due to COVID-19



Features

  • NEW Playground Equipment

COMPLETED FEBRUARY 2021 (Click to view project timeline)

Project Updates:

  • SEPTEMBER 2020 - In contracting
  • JANUARY 2021 - playground equipment to be installed in early 2021
  • FEBRUARY 2021 - 100% Complete, playground has been installed
