Little Farms Park - Improvements

Visit Facility Page


(Click to enlarge)

New Features in Current Project Improvements:

  • NEWplayground equipment and wood mulch safety surfacing
  • NEW concrete walking loop
  • NEW drinking fountains, benches, and other site improvements
  • IMPROVED limestone parking

Project Updates

  • August 2022 - Public Meeting was held on August 30, 2022, from 5-7 pm at Plank Road Park to determine future amenities. The public meeting was well attended with 19 attendees signing the sign-in register sheet. BREC had one-on-one conversations with the interested citizens, many of whom live in the surrounding neighborhood and frequent the park on a regular basis. At the public meeting, BREC presented two park improvement options.
    Option ‘A’ would concentrate funds on constructing a new children’s playground. Under Option ‘A’, the remainder of the park would remain open green space.

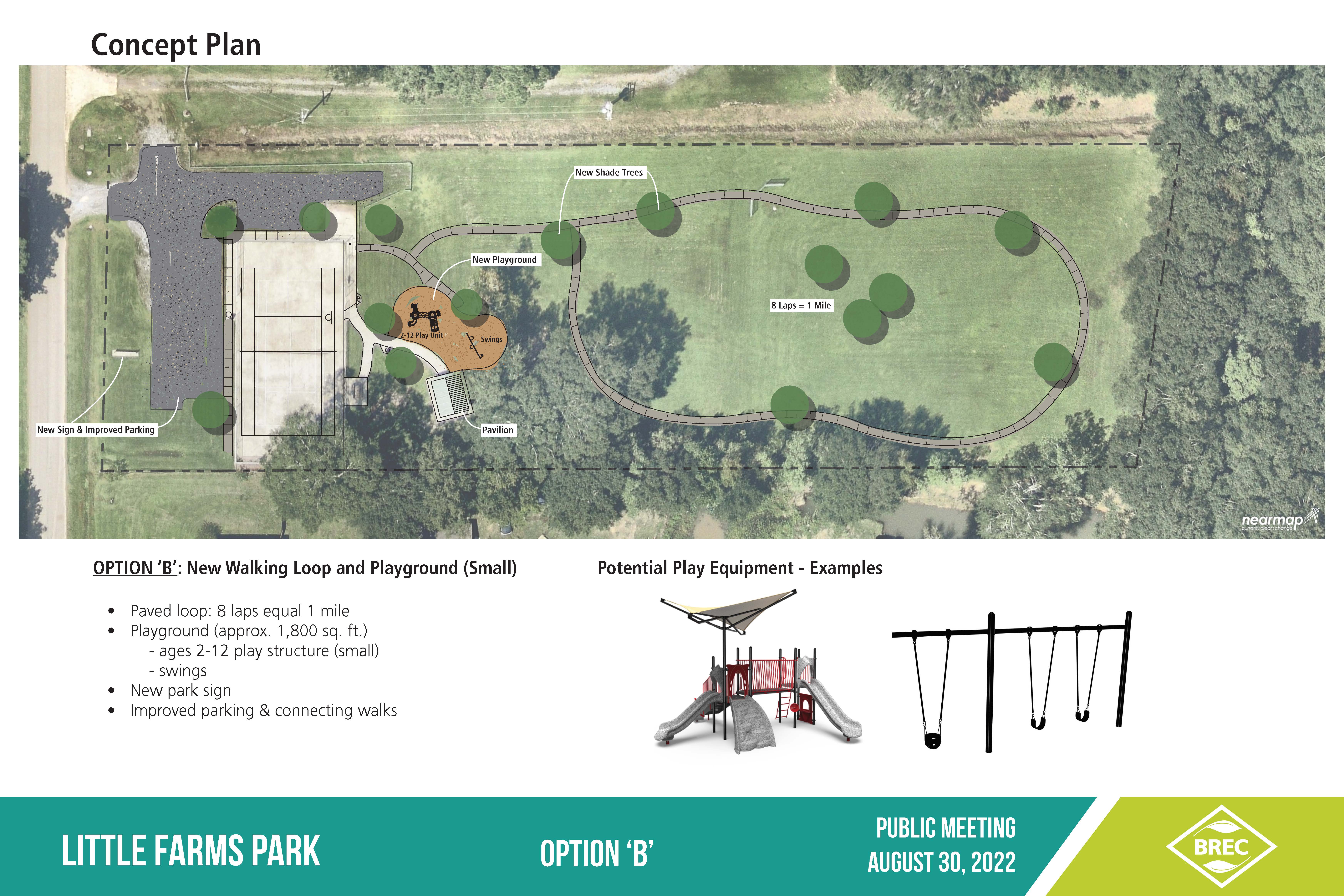

    Option ‘B’ would split funding between a smaller playground with fewer play activities, and a new walking loop, which would be approximately an eighth of a mile in length.
  • October 2022 - After reviewing the results from the online public input survey and the in-person public meeting it was determined that a new playground featuring a small play structure and swings with a walking loop around the park will serve the neighborhood well. Construction documents are underway with construction to begin within the next two months.
    Click here to view full survey results
  • NOVEMBER 2022 - 3% Complete; project has bejun on the dirtwork for the walking loop and starting setting forms for concrete.
  • February 2023 - 15% Complete; Due to wet weather, progress has not increased. Concrete has been poured for half the walking loop.
  • March 2023 - 25% Complete; Walking loop is completed and procurement of playground equipment is underway.
  • April 2023 - 35% Complete, Walking loop completed and connecting walks continuing with concrete pours to take place soon and drainage work for playground underway.
  • May 2023 - 50% Complete, Playground equipment ordered and awaiting delivery, construction continues with connecting walks and drainage work for playground
  • June 2023 - 60% Complete, awaiting playground equipment delivery and installation.  All connecting walks are completed, ADA parking has been installed.
  • July 2023 - 60% Complete, playground equipment scheduled to be installed in early August.
  • September 2023 - 90% Complete, Playground equipment has been installed and finalizing project before opening to public.
  • October 2023 - 92% Complete, Playground equipment is open to public.  Tree planting and landscaping to occur shortly.
  • November 2023 - 92% Complete, tree planting and landscape pending.
  • December 2023 - Landscaping to be completed Jan 2024
  • January 2024 - 100% complete

Improvements Completed January 2024
